Pontoon work boat with an enclosed cab moving across the flat surface of an industrial lagoon, bare treeline on the far bank

Water Solutions

Find out what is in the pond before you price the cleanout

A bathymetric sludge survey puts a boat on the water and comes back with a contour map of the bottom, a real volume in dry tons, and a scope of work you can put out for bid. No draw-down, no taking the cell out of service.

1 day
on the water for a typical cell
Zero
draw-down — the pond stays in service
GPS
referenced sonar transects, not pole soundings

How a survey runs

From a boat on the water to a scope you can bid

Order matters here: you cannot characterize material you have not located, and you cannot scope a cleanout without a volume.

  1. Get on the water

    A shallow-draft survey boat launches from the bank — no dewatering, no draw-down, no taking the pond out of service. Most cells are covered in a single day.

    ResultThe pond keeps operating throughout.

  2. Run the transects

    Dual-frequency sonar runs a gridded pattern across the cell, logging water depth and sludge depth against GPS position at every point along the line.

    ResultA dense point cloud rather than a handful of pole soundings.

  3. Map the bottom

    The survey data is worked up into a bathymetric contour map of the cell showing sludge thickness across the whole footprint, the position of the liner or hard bottom, and where the accumulation actually sits.

    ResultYou can see the problem instead of estimating it.

  4. Characterize the material

    Core samples go to the Spectrum laboratory for solids content, settling behavior, dewaterability and any waste characterization the disposal route will require.

    ResultDetermines whether it dewaters, and where it can go.

  5. Scope the cleanout

    Volume, material behavior and disposal route resolve into a real scope of work: how much comes out, how it gets dewatered, what it costs to haul and where it lands.

    ResultA document you can bid, budget or build a capital request around.

What you get

Survey deliverables

Everything procurement, engineering and the plant manager each need out of the same day on the water.

Bathymetric Contour Map

A GPS-referenced map of the cell showing water depth, sludge depth and the position of the hard bottom or liner across the full footprint.

Why it matters

Shows where the material is, which is what determines how it comes out.

Sludge Volume

Accumulated solids quantified in cubic yards and in dry tons, along with remaining freeboard and lost storage capacity.

Why it matters

Every number in a dredging quote is derived from this one. Get it wrong and the change orders follow.

Material Characterization

Laboratory results on solids content, settling and dewaterability, plus waste characterization where the disposal route calls for it.

Why it matters

Decides whether the material dewaters on site or gets hauled wet — the single largest cost in the project.

Inside the laboratory

Capacity & Trending

Current capacity against design capacity, and accumulation rate where a prior survey exists to compare against.

Why it matters

Turns "the pond looks full" into a maintenance interval you can plan and budget for.

Recommended Approach

The removal method that suits the material and the site — hydraulic dredging, mechanical excavation or a combination — with the dewatering train sized to match.

Why it matters

The method has to suit the material. Choosing it from a volume alone is how projects go over.

Dredging services

Scope of Work

A written scope covering removal, dewatering, transport, disposal and site restoration, structured so it can go straight out for competitive bid.

Why it matters

Most plants know the pond needs cleaning and have nothing they can put in front of procurement.

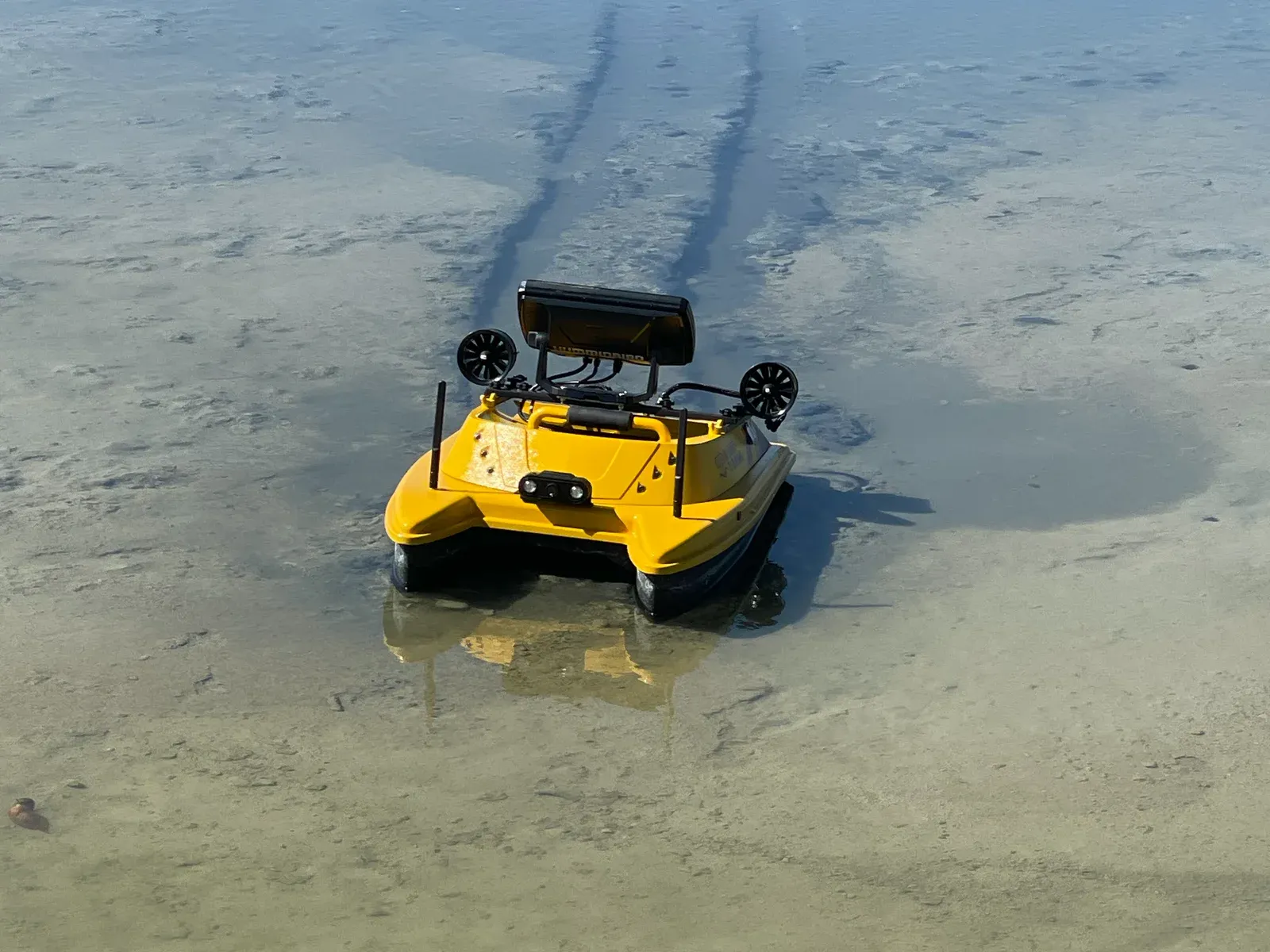

Yellow remote-controlled survey boat with a sonar head unit crossing a shallow pond, its track marks trailing through the sediment behind it

Why it pays for itself

The survey is where the cleanout budget is actually decided

Dredging is priced on volume and disposal is billed by weight, so the two numbers that set the cost of the whole project are settled before a dredge ever arrives. A pond scoped from a guess gets bid from a guess, and the correction shows up as a change order once the work is under way.

A survey replaces both guesses with measurements, and the laboratory work answers the expensive question early: whether the material dewaters on site or gets hauled wet. Run through Turbo Phase Separators and fast-flow trailers, the same tonnage leaves in roughly half the loads — but you need to know what the material is before you can commit to that.

  • Volume in cubic yards and dry tons, not an estimate
  • Dewaterability established before the disposal route is chosen
  • All bidders pricing against the same numbers

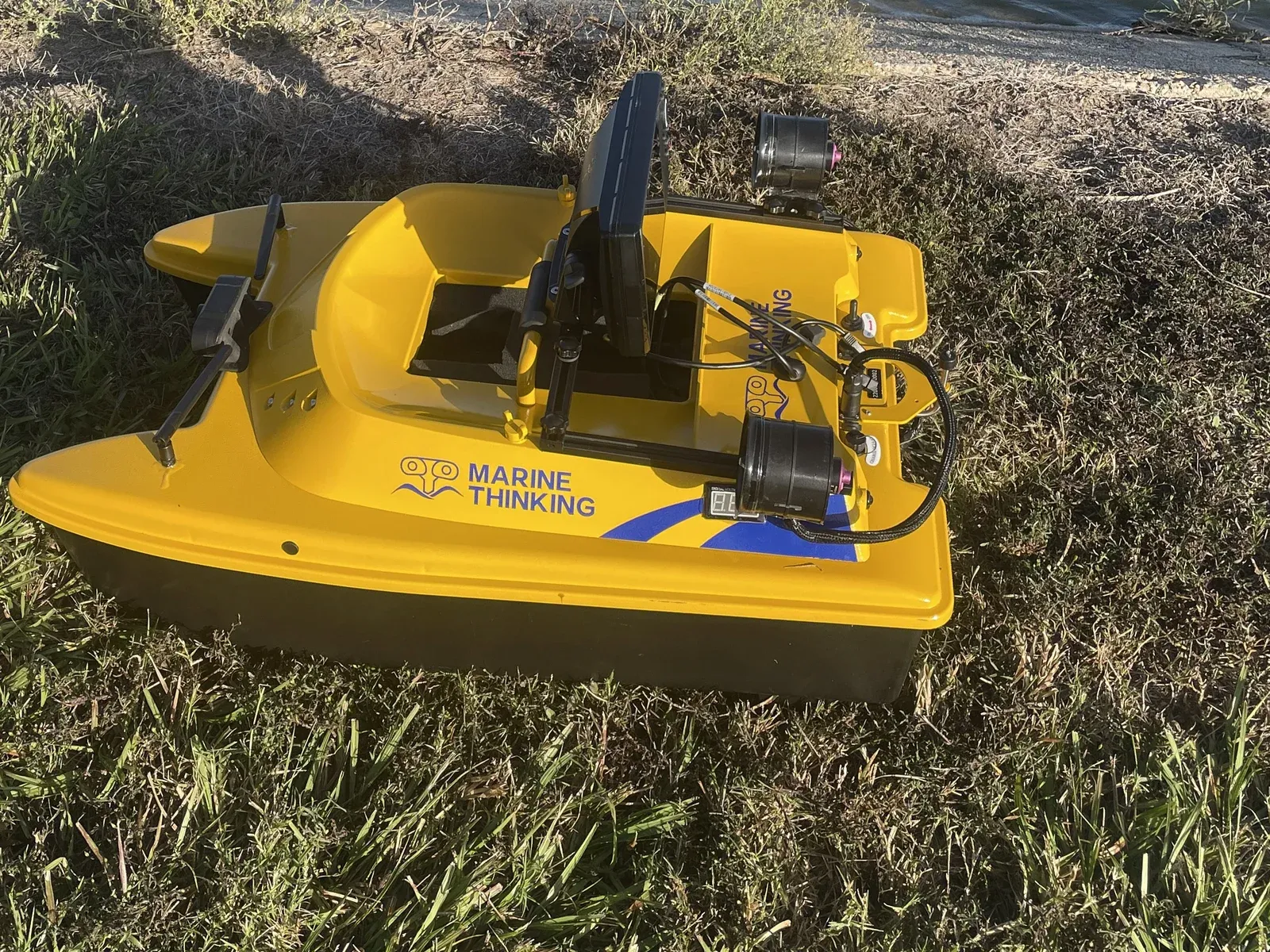

Close-up of the yellow remote survey boat on the grassy bank at the water's edge, sonar display and sensor pods mounted on deck

And then the work

Written by the crew that has to execute it

Spectrum surveys ponds because Spectrum cleans them out. The hydraulic and mechanical dredging fleet, the dewatering train and the disposal route all sit in the same company, which is why the recommended approach comes with real numbers behind it rather than a method chosen off a list. If you take the scope out to bid and someone else wins it, the survey still did its job — you found out what was in the pond.

Dredging services

FAQs

What is a pond sludge survey?

A survey boat runs sonar transects across the cell, logging water depth and sludge depth against GPS position. Worked up, that becomes a contour map of the bottom and a real volume of accumulated solids — how much is in there, how thick it is and where it sits. Core samples then establish what the material actually is.

Do we have to take the pond out of service?

No. The survey runs off a shallow-draft boat on the surface, so the cell keeps operating and there is no draw-down or dewatering to arrange. Most ponds and lagoons are covered in a single day.

Why survey before requesting cleanout bids?

Because without a volume, every bid you receive is a guess, and the change orders arrive once the dredge is on site. A survey gives all bidders the same numbers to price against, which is what makes the quotes comparable — and it means you find out what the material is before you have committed to a disposal route.

Will Spectrum help write the scope of work?

Yes, and that is most of the value. Spectrum turns the survey into a scope covering removal, dewatering, transport and disposal, written so it can go out for competitive bid. We do the dredging too, so the scope comes from people who have to execute against this kind of document rather than only write them.

Is the survey chargeable?

The survey is a paid engagement — there is a boat, a crew and laboratory work behind it. It is priced as its own scope and it stands on its own: the map, the volume and the recommended approach are yours whether or not Spectrum does the cleanout.

How often should a pond be surveyed?

Ponds in active industrial service are usually worth surveying every three to five years, and sooner where the influent has changed or freeboard is getting short. A second survey against a first also gives you an accumulation rate, which is what turns cleanout from an emergency into a planned interval.

Customers served

Who Spectrum works for

Refineries, chemical plants, terminals and mills bring Spectrum their ponds and lagoons — most of them on recurring site contracts rather than one-off jobs.

Four buckets, one call

Four service lines. One phone call.

Water, Environmental, Carbon, and Equipment run as one team under one contract — so you brief a single crew and get an answer, not a referral.

  • Water
  • Environmental
  • Carbon
  • Equipment
